Automotive Sewing Case Study: What 12 Weeks of Machine Data Reveal

29. October 2026

In a 12-week Clouver pilot on an automotive sewing line with 10 machines, output per productive machine-hour rose by 9.3%, defects per hundred units fell by 31.5% and stops per week fell by 20%. None of these gains required new machines. They came from a team acting on what the machine data made visible. This case study shows the figures, how they were measured and what their limits are.

The customer is an automotive supplier in Asia. For confidentiality reasons we cannot name the company or show photos from the shop floor. Every figure in this article was measured directly on the machines and has not been adjusted. If you want to know how the measurement itself works, see our overview of Clouver IIoT monitoring.

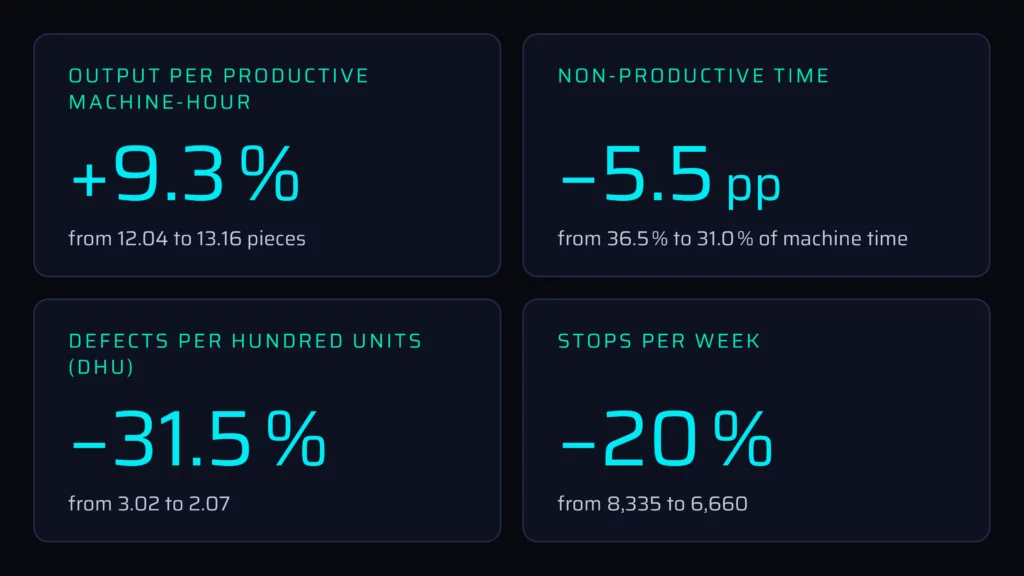

Automotive sewing case study: key results of the Clouver pilot, week 4 versus week 12

Key figures at a glance

Metric Week 4 (first full production week) Week 12 (last pilot week) Change
Output per productive machine-hour 12.04 pieces 13.16 pieces +9.3%
Non-productive time (share of machine time) 36.5% 31.0% −5.5 percentage points
Defects per hundred units (DHU) 3.02 2.07 −31.5%
Machine stops per week 8,335 6,660 −20%
Station time at the slowest station 44.6 s 39.5 s −11.5%

The Right First Time rate reached 97.9% in the last pilot week. Across the whole pilot, 38,033 pieces were inspected at the end of the line.

The pilot setup: one line, ten machines, twelve weeks

The pilot ran on one sewing line in automotive production. The line has 10 sewing machines and produces one product in several variants (left and right versions). Clouver captured four data streams:

  • machine states (productive, idle, stopped, switched off)
  • piece counts
  • energy consumption per machine
  • the result of the end-of-line quality inspection for every piece

The twelve weeks fell into three phases:

Weeks Phase Used for comparisons?
1 to 3 Commissioning, no operator logged in yet No
4 to 6 Operator training Yes, flagged
7 to 12 Stable operation Yes

All comparisons in this article therefore run from week 4 to week 12. The commissioning weeks behave differently in the data and are excluded.

Output: +9.3% per productive machine-hour

Output per productive machine-hour rose from 12.04 to 13.16 pieces. This metric divides the number of finished pieces by the hours in which the machines were actually sewing. It does not depend on whether operators logged in at the machine, so it stays comparable from week to week.

The increase did not happen gradually. It coincides with the end of operator training. For a plant manager this is a useful finding in itself: the length and quality of training show up directly in the output figure, which makes training a measurable cost factor.

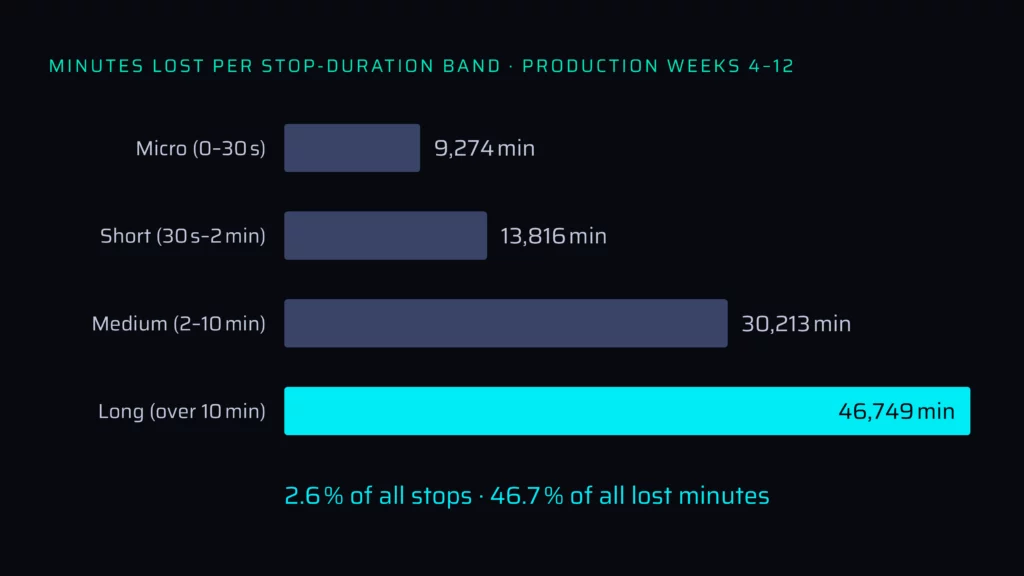

Minutes lost per stop-duration band in weeks 4 to 12: stops longer than 10 minutes cause 46.7% of lost machine time

Downtime: 2.6% of stops cause almost half of the lost time

Stops per week fell from 8,335 to 6,660. The typical stop duration (median) stayed at 15 seconds throughout. The improvement therefore came from preventing stops, not from clearing them faster.

The key insight is how the lost minutes are distributed across stop lengths (production weeks 4 to 12):

Stop duration Minutes lost Share of lost minutes
Micro (0 to 30 s) 9,274 9.3%
Short (30 s to 2 min) 13,816 13.8%
Medium (2 to 10 min) 30,213 30.2%
Long (over 10 min) 46,749 46.7%

Stops longer than 10 minutes make up only 2.6% of all stops but 46.7% of all lost minutes. At the other end, 70% of all stops last less than 30 seconds. Nobody with a stopwatch and a clipboard can capture micro-stops at this scale. Sensors on every machine can.

What this means in practice: an escalation rule for every stop that runs longer than 10 minutes. That is a supervisor instruction, not an investment.

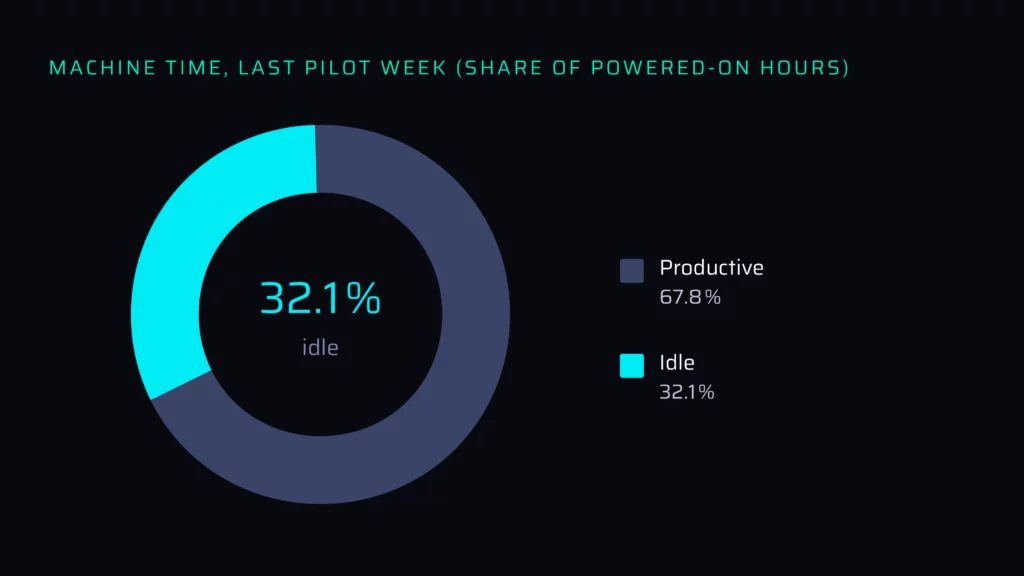

Machine time in the last pilot week: the sewing machines were idle for 32.1% of powered-on hours

Idle time: for a third of the powered-on time, the needle does not move

In the last pilot week, the machines were productive for 67.8% of the time they were switched on and idle for 32.1%. Measured against all shift hours, including the time the machines were switched off, the idle share hardly moved during the pilot (30.7% at the start, 30.9% at the end), while the output per productive hour went up.

This means the line’s largest remaining reserve is still untapped. Idle time is capacity that has already been paid for: the machine is on, the operator is present, but nothing is being sewn. Unlocking it requires better material flow and work distribution, not new equipment. Measuring this share continuously is also what OEE optimisation is built on.

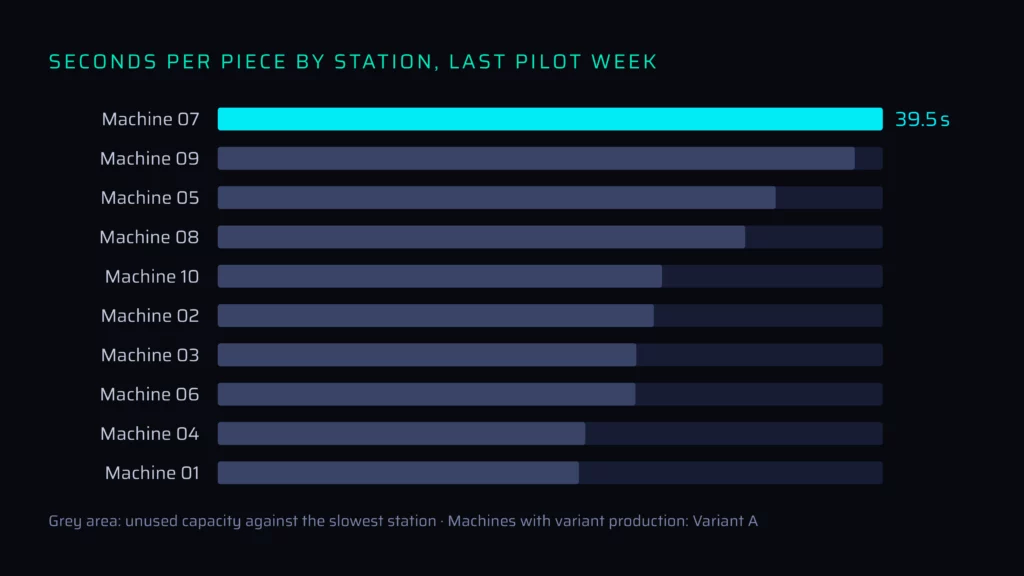

Seconds per piece by station in the last pilot week, with unused capacity measured against the slowest station

Capacity: 123 seconds per piece that no one was using

The data shows the seconds each station needs per piece. In the last pilot week, the slowest station needed 39.5 seconds, down from 44.6 seconds at the start (−11.5%). Measured against that station, the other stations together had 123 seconds of unused capacity per piece. The balance between stations improved from 69.5% to 74.0% during the pilot.

Two details only became visible through continuous measurement:

  • The slowest station moved between two machines during the pilot. A one-off time study would have caught only one of them.
  • Redistributing work around the current slowest station frees this capacity without buying a single machine. The estimated effort is one to two days.

Our guide on how to balance a sewing line with takt time and cycle time describes this redistribution step by step.Quality: three defect types cause almost three quarters of all defects

Every piece leaving the line was inspected at the end of the line. The result, the defect type and the responsible station were recorded for each piece. Over the whole pilot, 1,185 defects were recorded:

Defect type Count
Open seam 438
Seam margin out of spec 221
Slack stitch 197
Improper stitch 78
Pinched seam 33
Other types 218

The top three defect types account for almost three quarters of all defects. Two further findings:

  • One station caused 20 times as many defects as the best station.
  • In the production weeks, 810 of 811 defects could be reworked. The defect rate is therefore mainly a rework cost, not a scrap cost.

DHU (defects per hundred units) fell from 3.02 to 2.07 during the pilot. A quality programme that targets the three most frequent defect types addresses most of the problem with the fewest changes.

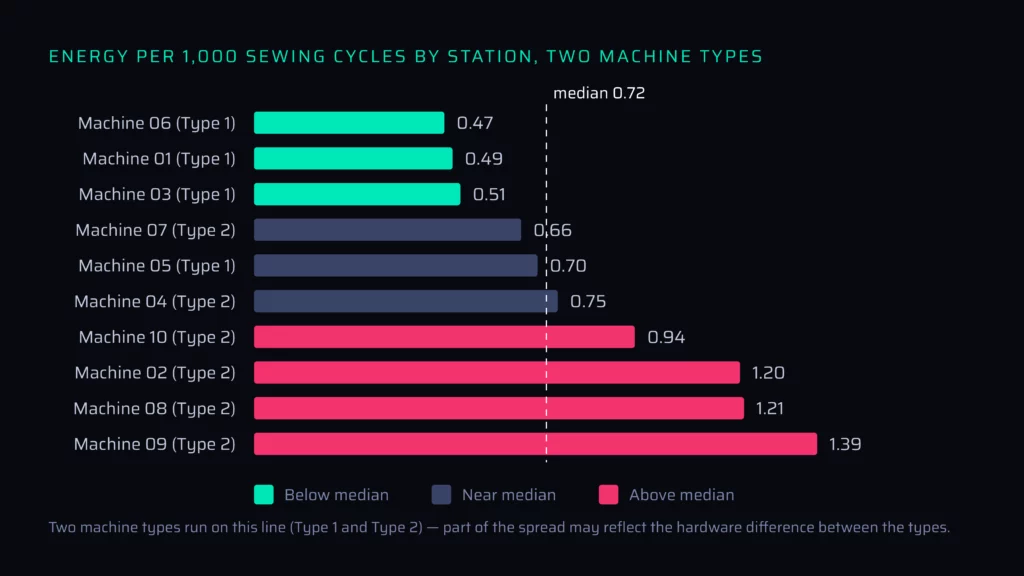

Energy per 1,000 sewing cycles by station: consumption ranges from 0.47 to 1.39 kWh across two machine types

Energy: 19.4% is consumed while the machines are idle

Energy savings were the benefit the customer expected most. Of 908 kWh measured over the twelve weeks, 176 kWh (19.4%) were drawn while the machines were idle.

The comparison per 1,000 sewing cycles shows how much consumption varies between stations:

Machine Type kWh per 1,000 sewing cycles
Machine 06 Type 1 0.47
Machine 01 Type 1 0.49
Machine 03 Type 1 0.51
Machine 07 Type 2 0.66
Machine 05 Type 1 0.70
Machine 04 Type 2 0.75
Machine 10 Type 2 0.94
Machine 02 Type 2 1.20
Machine 08 Type 2 1.21
Machine 09 Type 2 1.39

The median is 0.72 kWh. Two machine types run on this line, so part of the spread reflects the hardware. Even within Type 2, however, consumption ranges from 0.66 to 1.39 kWh, roughly a factor of two. Reducing idle consumption is a question of shutdown routines, not investment.

What only measurement reveals

Three figures did not exist before the pilot. All of them are machine-measured, not estimated:

Finding Figure Basis
Variant changeover 3% performance loss per left/right change 526 changes measured
Overtime 13% of all sewing cycles after the regular shift Overtime on 33 of 63 production days
Micro-stops 70% of all stops shorter than 30 seconds Every stop on every machine

The changeover figure is particularly relevant for planning. Switching between left and right variants of the same product costs far less than a full style change would.

Maintenance data shows a similar effect. Machine 04 needed the technician most often (26 calls, on average 3.9 minutes each). Machine 03 lost the most time (196 minutes in total, on average 17.8 minutes per stop). The machine with the most technician calls is not the one that loses the most time. The two problems need different answers, and both are only visible when every stop is recorded.Four levers without investment

Every lever comes directly from the pilot data:

No. Lever Data basis
01 Redistribute work around the current slowest station 123 s of unused capacity per piece
02 Quality programme for the three most frequent defect types Almost three quarters of all defects
03 Investigate the station with the most defects 20 times the defects of the best station
04 Escalation rule for stops longer than 10 minutes 46.7% of all lost minutes

How the figures were derived and what their limits are

Figures are only as useful as the method behind them. The most important points:

  1. Comparisons within the pilot. Measurement started at commissioning. There is no measured baseline from before the installation and no control line. All changes compare the line with itself over time.
  2. Commissioning and training are separated. Weeks 1 to 3 are excluded, weeks 4 to 6 are flagged. Part of the improvement coincides with the end of operator training.
  3. One line, one product. The results describe this line. They cannot be transferred directly to other lines or products.
  4. The headline figure does not depend on login discipline. Output per productive machine-hour is based on machine states, not on operator logins.

Four simple working habits keep the data meaningful: entering a reason code for every stop above a minimum duration, logging in at the machine, keeping daily targets and master data up to date, and a short one-off calibration session among the quality inspectors.

Clouver makes it visible, the team makes it happen

Clouver is the monitoring system. It measures every machine, every stop and every piece and turns them into live KPIs. It does not change the line by itself. The improvements in this pilot came from people acting on what the data showed them.

A Clouver pilot runs in three steps:

  1. Setup and training: the machines are connected without touching their control logic. Once data is flowing, the team is trained to work with it.
  2. Pilot phase: the line runs with live data for an agreed period until the KPIs stabilise and the concrete levers become visible.
  3. Impact review: an impact report with your own KPIs and concrete recommendations forms the basis for the next decision.

Scope, timeline and prerequisites are agreed before the start.
